• Funding program Investment Road and Rail Program
  • Status Completed
  • Transport mode Road
  • Expected start/finish Mid 2015 - Mid 2016
  • Estimated project cost $16,580,000
  • Australian Government contribution $8,290,000
  • Local Council/Shire Gladstone Regional Council
  • State QLD

Project description

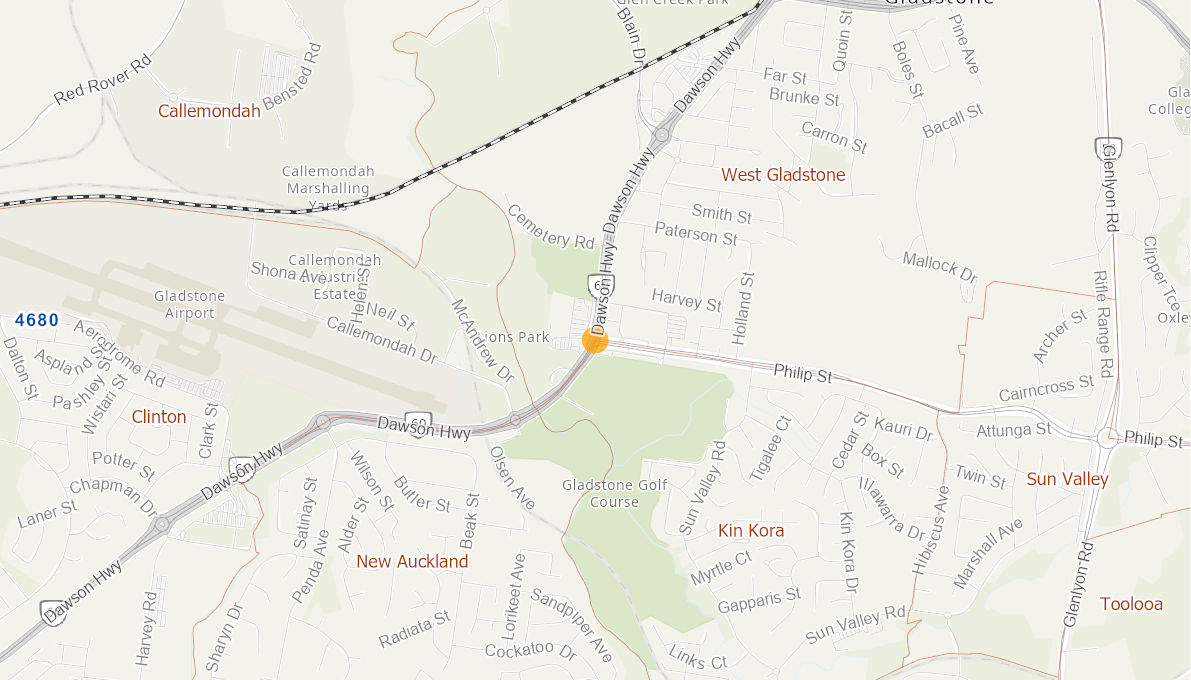

The project upgraded the Kin Kora roundabout at the intersection of the Dawson Highway and Philip Street in Gladstone into a fully signalised intersection.

Benefits

The project improves safety and traffic flow, including for heavy vehicles.

Funding

The Australian Government committed to provide 50 per cent up to  $12.5 million to upgrade the Kin Kora roundabout, based on an estimated project cost of $25 million, in partnership with the Queensland Government.

As the project was delivered under budget for $16.58 million, the final Australian Government contribution was $8.29 million.

Timetable

Construction commenced in May 2015 and was completed June 2016.  Minor finalisation works include fencing and electrical works  as well as footpath regrading was undertaken in early 2017 and was completed in March 2017.

Project last updated:

Disclaimer: The material contained in this site is made available on the understanding that the Department is not thereby engaged in rendering professional advice for a particular purpose. Before relying on the material in any important matter, users should carefully evaluate the accuracy, completeness and relevance of the information for their purposes and should obtain appropriate professional advice relevant to their particular circumstances.
