• Funding program Black Spot Projects
  • Status Completed
  • Transport mode Road
  • Expected start/finish Dec 2016 - Mar 2017
  • Australian Government contribution $142,035
  • Local Council/Shire Warren Shire Council
  • State NSW

Project description

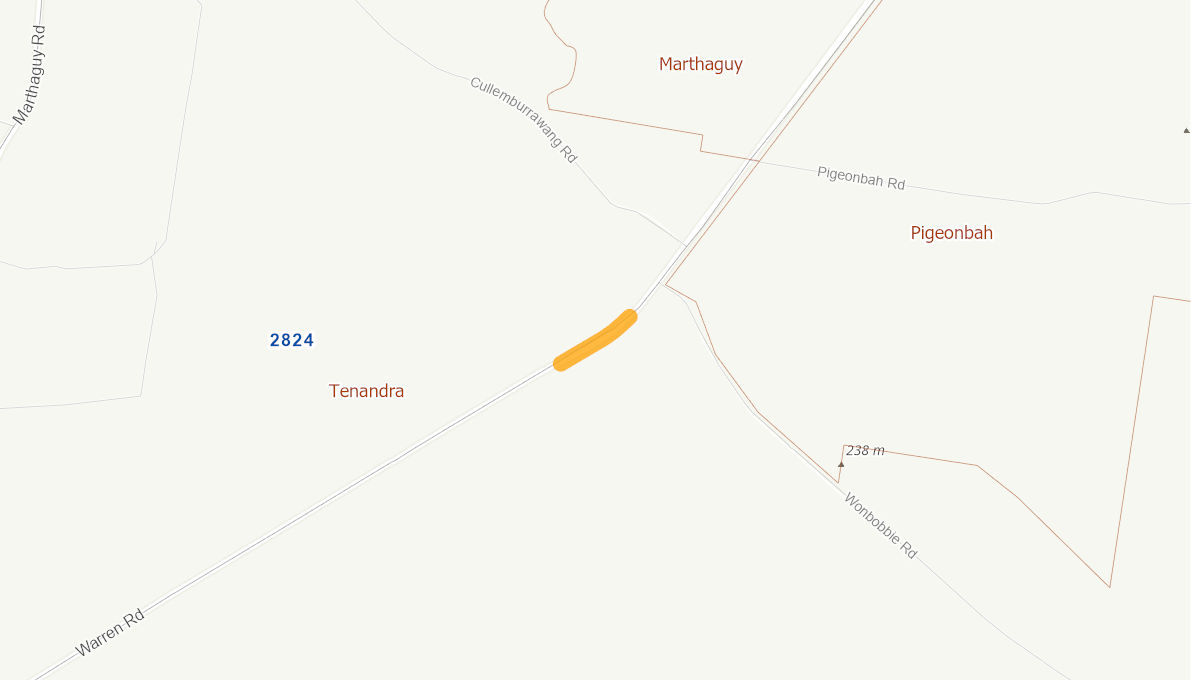

Mark barrier line and edge lines, install shoulder from no shoulder/unsealed to 0.5-1m sealed on straight, upgrade seal to high level non-skid surface, install new curve and advisory speed signs, remove clearzone hazards

Project last updated:

Disclaimer: The material contained in this site is made available on the understanding that the Department is not thereby engaged in rendering professional advice for a particular purpose. Before relying on the material in any important matter, users should carefully evaluate the accuracy, completeness and relevance of the information for their purposes and should obtain appropriate professional advice relevant to their particular circumstances.
