• Funding program Roads to Recovery Program
  • Status Completed
  • Transport mode Road
  • Expected start/finish May 2020 - Jun 2020
  • Estimated project cost $181,570
  • Australian Government contribution $141,908
  • Local Council/Shire City of Belmont
  • State WA

Project description

Existing asphalt road surface has pasted its useful life and is starting to show excessive wear and stone loss along both kerb lines and environmental cracking along the surface plus rusting out of existing drainage structures at road surface.

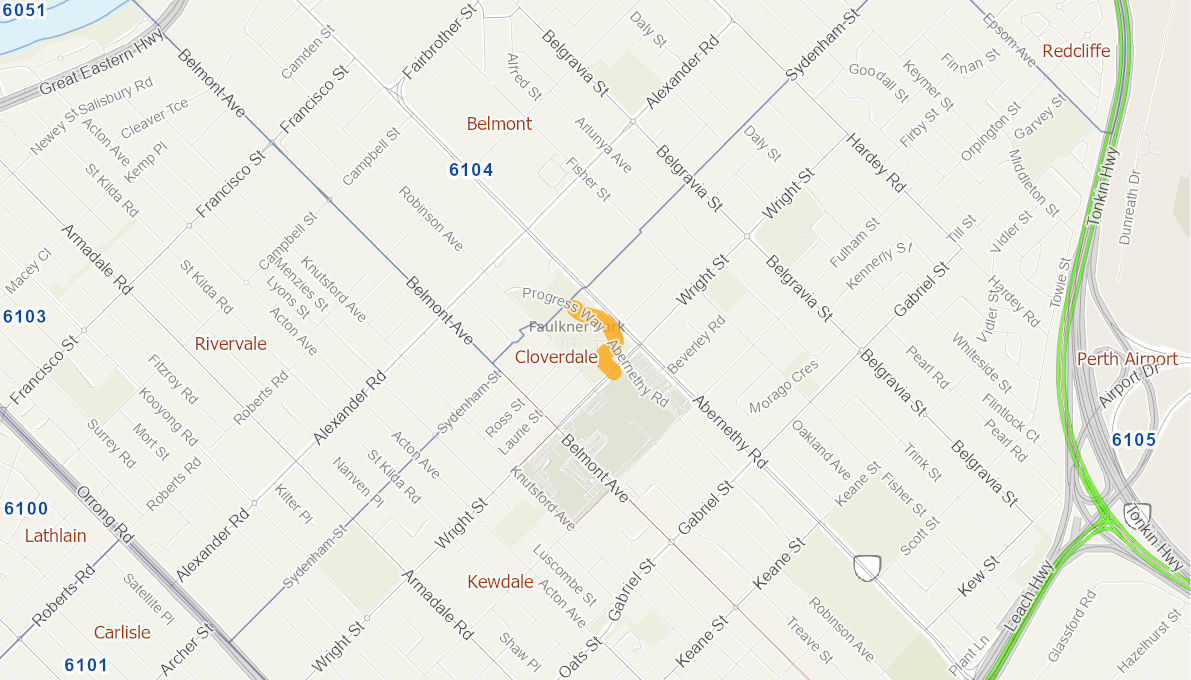

Length, width and area of job: 313m x 7.2m x = 2,246m2. Existing asphalt surface to be milled off over full length of the project, minor kerb repairs made and four existing drainage pits to be reconstructed with new gully grates installed.

Total cost of proposed project is $181,570

Project last updated:

Disclaimer: The material contained in this site is made available on the understanding that the Department is not thereby engaged in rendering professional advice for a particular purpose. Before relying on the material in any important matter, users should carefully evaluate the accuracy, completeness and relevance of the information for their purposes and should obtain appropriate professional advice relevant to their particular circumstances.
